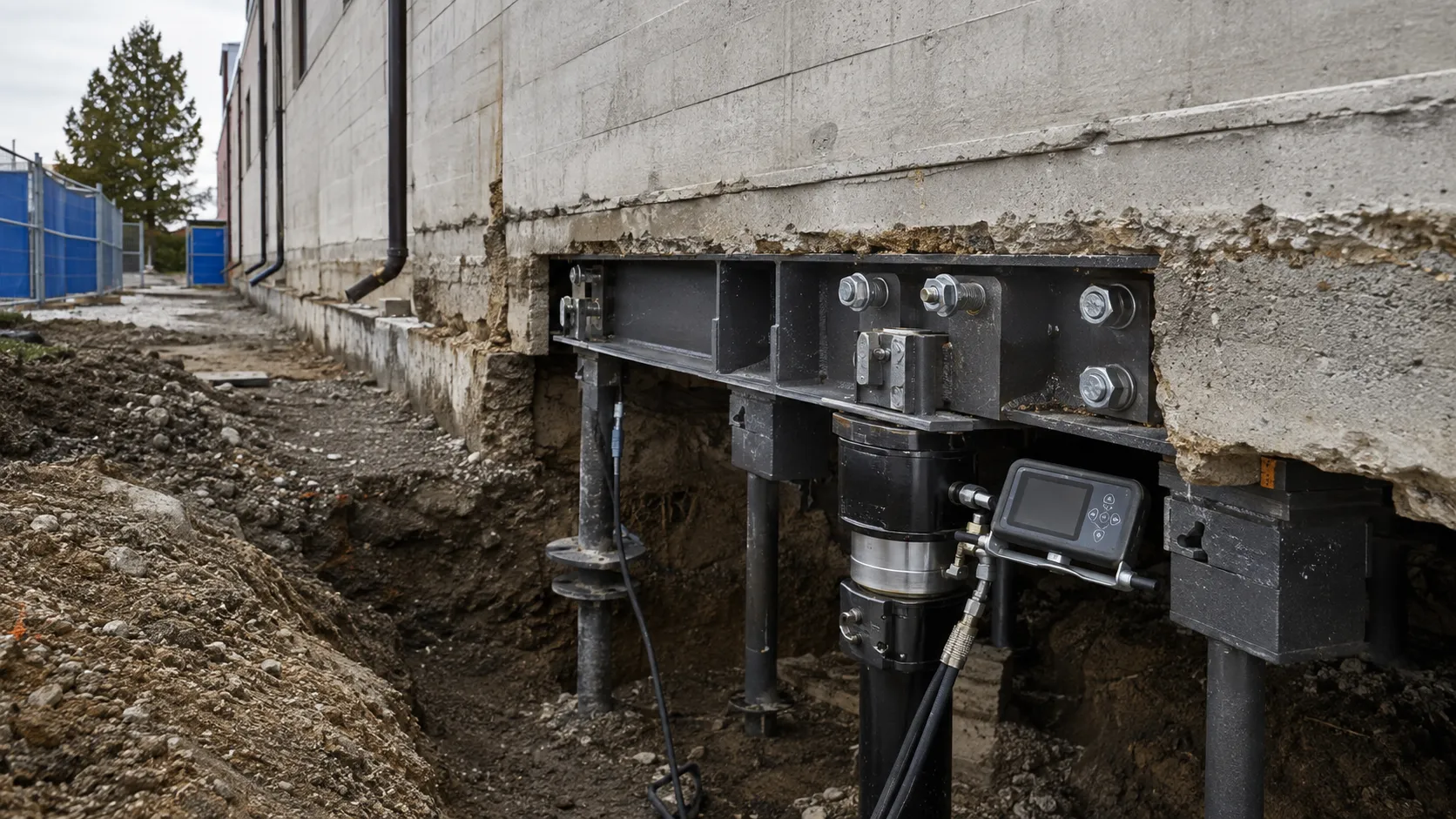

Helical pile underpinning transfers foundation loads to deeper competent soil using steel shafts with helix plates rotated into the ground, then connected by engineered brackets, caps, or grade beams. Harrowgate installs helical underpinning for commercial projects across Toronto and the GTA where access, vibration, spoil generation, and rapid load transfer favour a torque-installed system.
Underpinning succeeds when the temporary load path is defined before soil or concrete is removed. We establish survey control, verify services and existing geometry, build only the authorised stage, keep excavations stable and reasonably free of water, inspect concealed work, and transfer load only after the new support has reached the engineer's stated acceptance criteria.

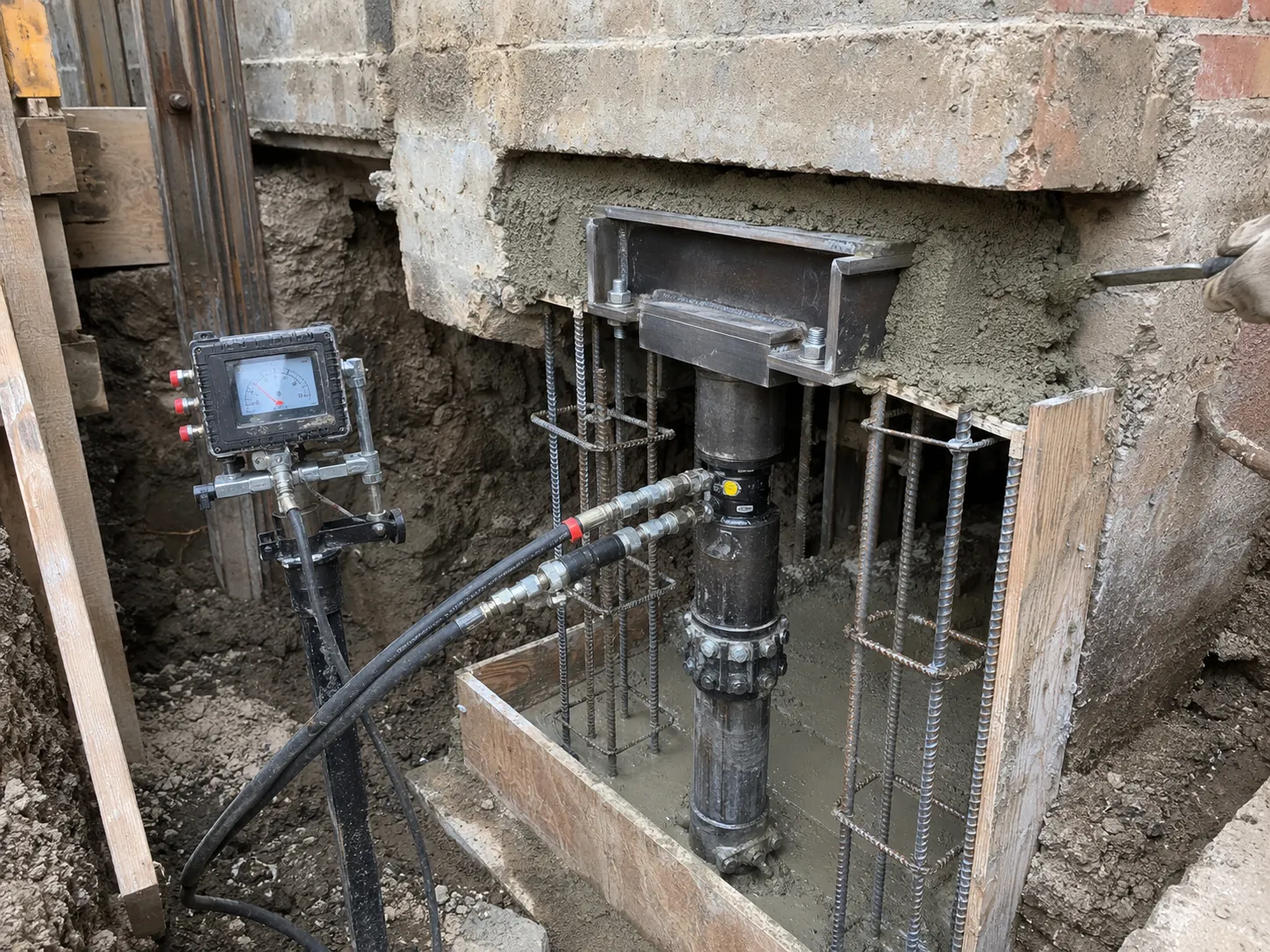

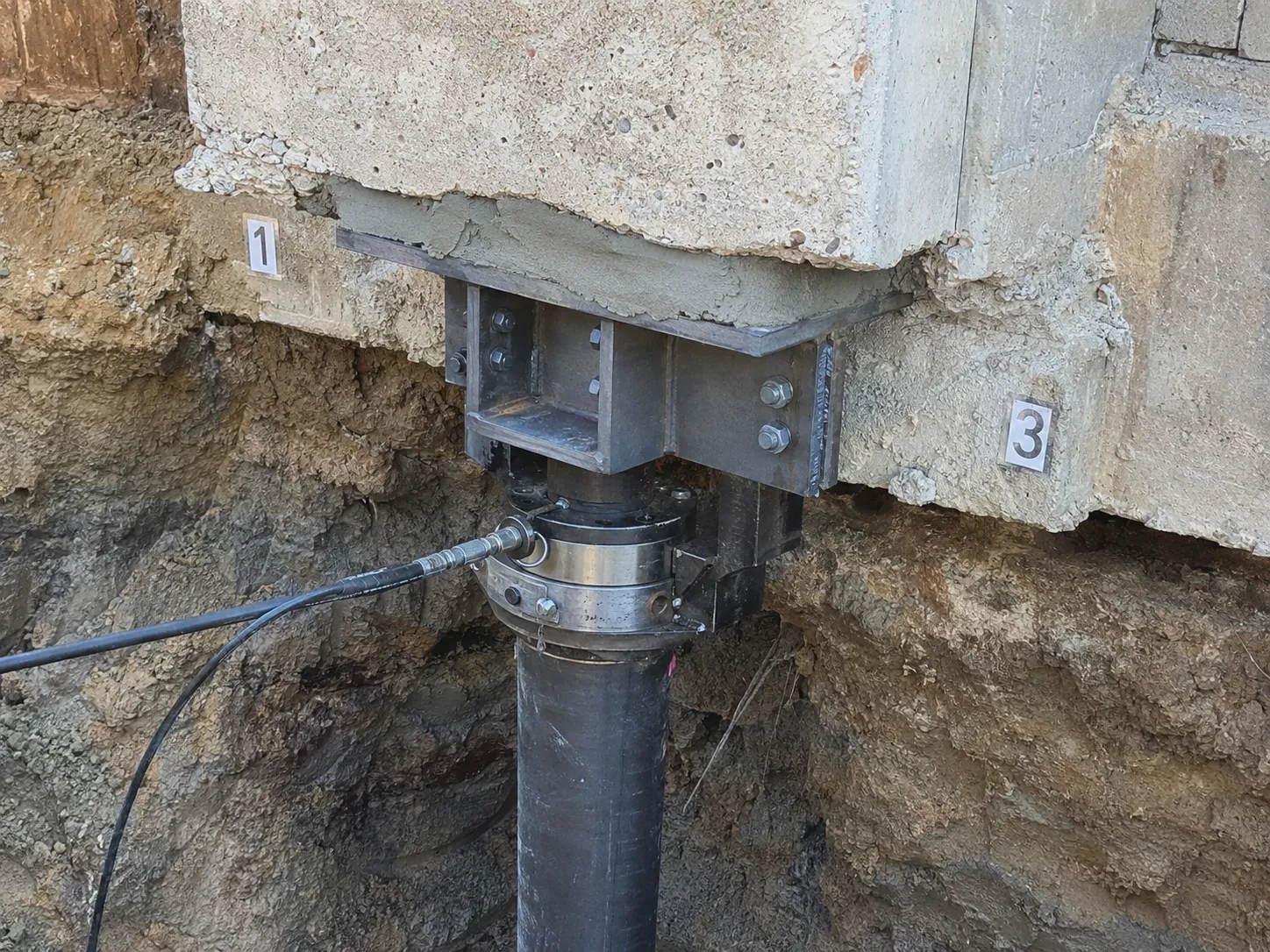

We expose the footing only where required, verify its condition, and set the pile location and inclination from the bracket or beam design. A hydraulic drive head advances each lead section while the crew records depth, rotation, shaft extensions, and installation torque. Extensions continue until the specified termination criteria are achieved within the accepted soil profile.

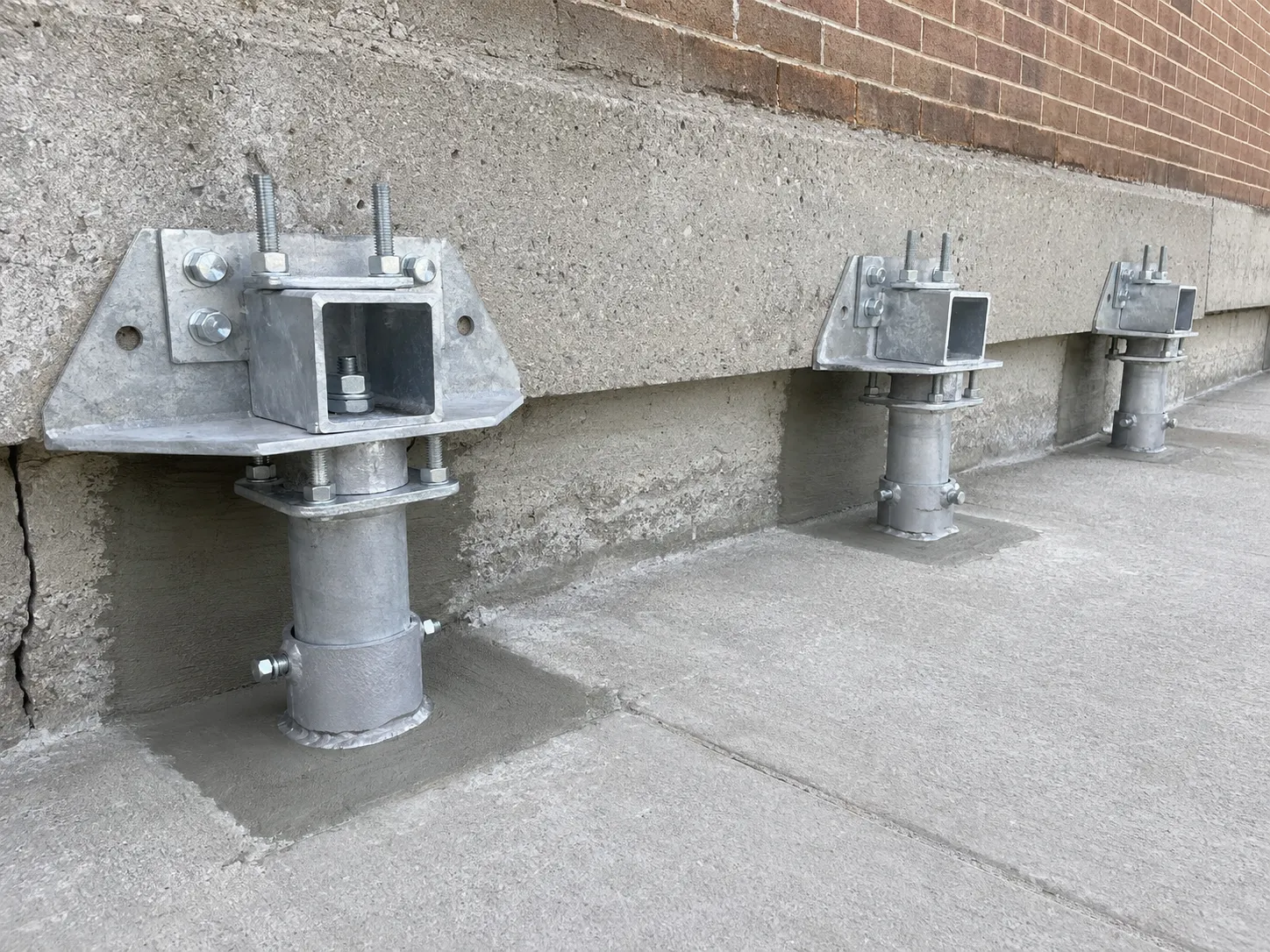

The pile is cut to elevation, fitted with the designed new-construction cap or retrofit bracket, and connected to sound concrete or a new reinforced beam. Where preload is specified, jacks engage the pile in measured increments before the bracket is locked. Proof or verification testing is completed at the stated frequency.
Every active element has an identity, status, and release condition. Daily records show what was exposed, the soil or founding response, temporary support, water, dimensions, materials, inspections, concrete or grout placement, strength evidence, pile or jack data where applicable, and movement readings. An unexpected condition is stabilized and reviewed before the opening is enlarged or the next stage begins.
Every dimension and capacity comes from the sealed structural and geotechnical design, not a field rule of thumb. We control founding elevation, open length, pile or bearing capacity, reinforcement, steel, concrete and grout, load-transfer contact, sequence, testing, inspection, and movement. Applicable OBC provisions, Ontario construction requirements, CSA standards, and project-specific OPSS clauses govern the work.
The design identifies shaft type and steel grade, helix number and diameter, corrosion allowance or protection, spacing, inclination, minimum embedment, torque correlation, minimum and maximum installation torque, structural capacity, buckling considerations, bracket eccentricity, testing, and load-transfer sequence. Torque is an installation control, not the only proof of capacity, and must be interpreted within the geotechnical profile. OBC and applicable CSA steel and concrete requirements govern structural components. We provide pile-by-pile depth and torque logs, extension counts, cut-off elevations, bracket records, tests, and final survey.
Ontario construction rules require services to be located and marked before excavation, hazardous services to be controlled, adjacent structures to receive the written precautions specified by an engineer, and worker excavations to be reasonably free of water. Soil, surcharge, safe access, edge protection, and support systems are managed as part of the underpinning operation, not left outside the foundation detail.
The failures buyers worry about are settlement, cracking, loss of bearing, unstable excavations, damaged services, incomplete contact, failed pile or concrete tests, water entry, and schedule delay. These problems usually begin at a concealed interface or an out-of-sequence opening. We prevent them with early exposure, numbered stages, engineered temporary support, documented inspections, strength holds, measured transfer, and monitoring.

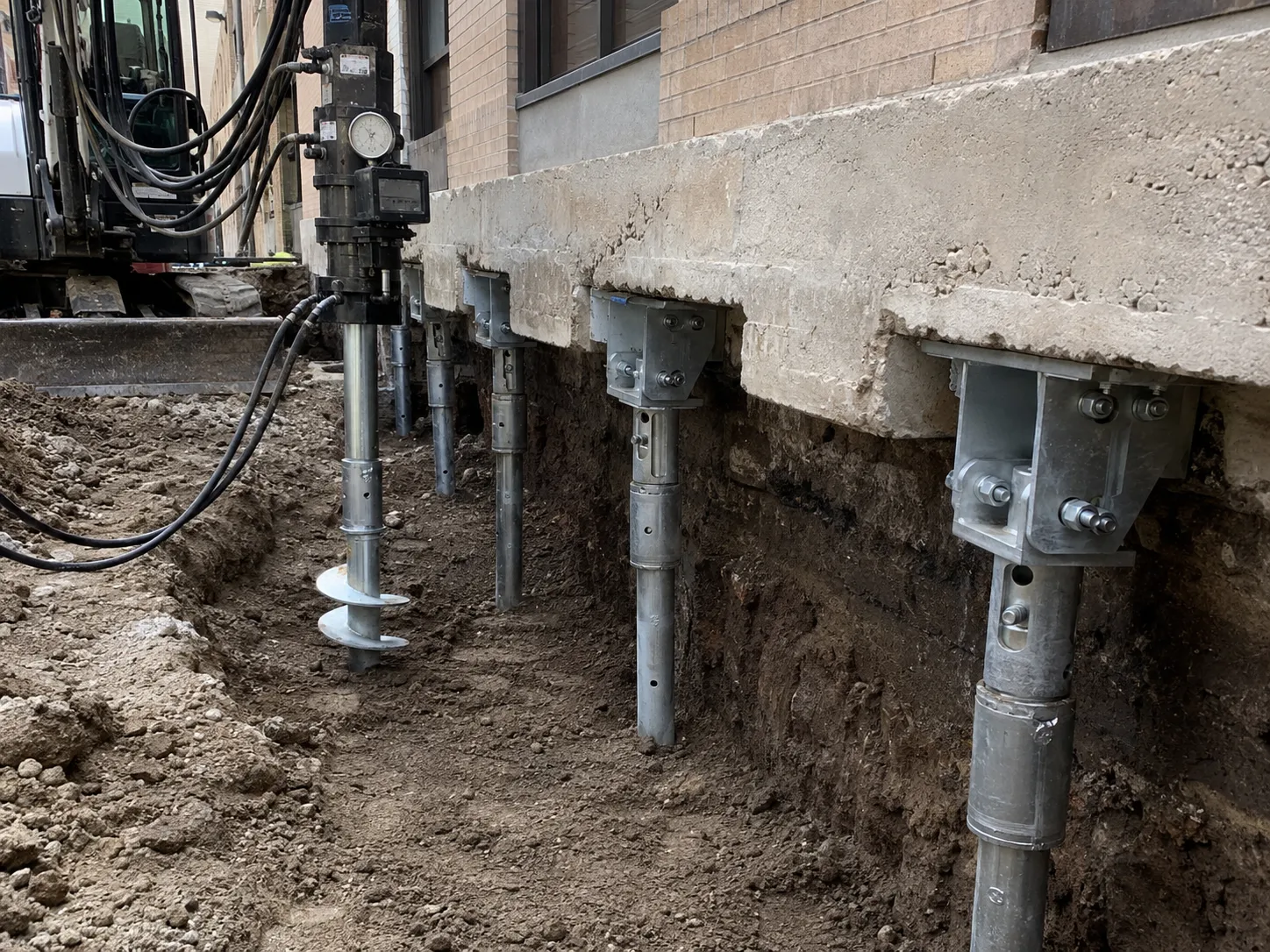

A helical pile can stop on a shallow obstruction before reaching the intended bearing zone, exceed shaft torque capacity, wander from the bracket, buckle in very soft soil, or achieve high torque from debris that does not represent reliable support. Brackets can rotate or crush weak footing concrete when load transfer is eccentric. We compare torque with depth and borehole information, use pilot holes only when accepted, verify footing soundness, test where specified, maintain alignment, and obtain revised direction when termination criteria conflict.
Weather, pumping, vibration, building use, material storage, and work by other crews can change the temporary condition. We review those influences each shift. If a movement level, test criterion, bearing requirement, or inspection hold is not satisfied, the affected work stops, remains supported, and is referred to the engineer before load or excavation progresses.
Have drawings for helical pile underpinning? Send them over and we will scope it.
We sequence helical pile underpinning from the sealed drawings and the existing load path. We expose the footing only where required, verify its condition, and set the pile location and inclination from the bracket or beam design. Each stage remains within its stated opening limit, receives the specified support and inspection, and reaches its concrete, grout, pile, connection, or transfer.
Commercial underpinning is structural work and is planned from sealed engineering documents. Permit and submission requirements depend on the municipality and full project scope, but excavation, foundation changes, temporary support, and load transfer must be coordinated with applicable OBC requirements and approved documents. We confirm required inspections and hold points before opening the first stage.
The selection follows existing loads and condition, footing geometry, soil and groundwater, depth to competent support, access, headroom, vibration limits, neighbouring assets, property rights, and the proposed permanent work. Shallow competent bearing may suit concrete pins. Deep weak soils or concentrated reactions may require piles, beams, brackets, needles, or ground treatment.
Often it can, when the engineer's temporary load path and the project phasing support continued use. We isolate work zones, maintain required exits and services, control dust, noise, vibration, and deliveries, and schedule disruptive transfers around operations. Feasibility depends on structural condition, access, sensitive equipment, utility interruptions, and the response plan for unexpected movement.
We establish baseline elevations and condition observations before disturbance, then read the specified survey points, crack gauges, tilt points, or other instruments at stage and time intervals. Results are compared with engineer-defined review and action levels. A rapid change, unusual trend, or visible distress triggers confirmation, stabilization, notification, and a hold on affected work.
We keep the exposed area stable, document dimensions and material condition, and notify the engineer before extending demolition or excavation. Footing depth, width, reinforcement, masonry quality, hidden grade beams, services, and previous alterations can change the load-transfer detail. The affected stage continues only after the design is confirmed or revised for the observed condition.
The main drivers are investigation findings, number and depth of stages, soil and groundwater, working headroom, hand excavation, temporary support, pile depth, drilling obstructions, structural steel, reinforcing, concrete and grout, load testing, monitoring, inspection timing, spoil routes, occupied operations, and reinstatement. A complete sequence and early exposures reduce uncertainty before full production begins.
The project package can include investigation records, pit or pile logs, bearing approvals, reinforcement inspections, concrete tickets and test results, grout records, steel and connection inspections where specified, pile tests, jacking and preload readings, monitoring plots, field changes, photographs, and as-built locations. The final list follows the project specification and engineer's inspection plan.
